2026-04-29__001_synthetic_mine_throughput__claude-code__claude-sonnet-4-6__vanilla-max

Date: 2026-04-29 · Benchmark: 001_synthetic_mine_throughput · Harness: claude-code · Model: claude-sonnet-4-6 (vanilla-max) · ? Unrecorded

Scores

Category Points Max
Conceptual modelling 18 20
Data and topology 13 15
Simulation correctness 15 20
Experimental design 13 15
Results & interpretation 14 15
Code quality 8 10
Traceability 4 5
Total 85 100

Run metrics

Evaluation report

Scenario Mean throughput
baseline 12,446.67
trucks_4 8,163.33
trucks_12 12,676.67
ramp_upgrade 12,466.67
crusher_slowdown 6,423.33
ramp_closed 12,446.67

Source files

Downloads

Conceptual model

Conceptual Model: Synthetic Mine Throughput Simulation


System Boundary

Included

Excluded


Entities

Trucks

The primary active entity. Each truck moves through the system in a continuous cycle:

Dispatch → Travel (empty) → Queue at loader → Load →
Travel (loaded) → Queue at crusher → Dump → [repeat]

Trucks carry a fixed payload of 100 t. Loaded trucks travel at 85% of the empty speed on each road segment. All 12 trucks start the shift at the parking node (PARK). A fleet scenario uses the first N trucks from the list.


Resources

Loaders

One loader per ore face (L_N at LOAD_N, L_S at LOAD_S), each modelled as a SimPy Resource with capacity 1. Only one truck can be served at a time; others queue in FIFO order.

Primary Crusher

Modelled as a SimPy Resource with capacity 1. One truck dumps at a time; others queue.

Capacity-Constrained Road Segments

Road segments with capacity = 1 are modelled as SimPy Resource objects, allowing only one truck to traverse the segment at a time. The affected segments are:

Edge IDDescriptionDirection
E03_UPMain ramp (uphill)J2 → J3
E03_DOWNMain ramp (downhill)J3 → J2
E05_TO_CRUSHCrusher approachJ4 → CRUSH
E05_FROM_CRUSHCrusher approach returnCRUSH → J4
E07_TO_LOAD_NNorth pit face accessJ5 → LOAD_N
E07_FROM_LOAD_NNorth pit face returnLOAD_N → J5
E09_TO_LOAD_SSouth pit face accessJ6 → LOAD_S
E09_FROM_LOAD_SSouth pit face returnLOAD_S → J6

Events

EventDescription
dispatchTruck selects a loader and begins travel from its current node
edge_departTruck departs from one node toward the next on its route
loader_queue_joinTruck arrives at loader and joins queue
load_startTruck acquires loader resource and loading begins
load_endLoading complete; truck becomes loaded
crusher_queue_joinTruck arrives at crusher and joins queue
dump_startTruck acquires crusher resource and dumping begins
dump_endDump complete; ore tonnage recorded as delivered

State Variables

VariableDescription
truck.current_nodeCurrent location of each truck in the graph
truck.loadedBoolean flag: loaded or empty
truck.active_timeCumulative time spent in productive cycle activity
loader_resource.queueNumber of trucks waiting at each loader
crusher_resource.queueNumber of trucks waiting at crusher
road_resource.queueNumber of trucks waiting for a constrained road segment
state.tonnes_deliveredRunning total of ore delivered to crusher in the replication
state.cycle_timesList of per-cycle durations (dispatch to dump-end)
state.loader_queue_timesList of time each truck spent waiting at a loader
state.crusher_queue_timesList of time each truck spent waiting at the crusher
state.crusher_service_timesList of dump service durations (for utilisation calculation)
state.loader_service_timesPer-loader list of load service durations

Assumptions

Derived from data

Introduced assumptions

Model note on the main ramp

The main ramp (E03_UP/E03_DOWN, J2↔J3) connects the lower haul road to the upper pit area. In steady-state cycling, trucks travel between loaders (at J5/J6 level, above J3) and the crusher (via J4, also above the ramp base). This means the ramp is only traversed during the initial dispatch from PARK at the start of the shift.

Additionally, the alternative bypass route (J2→J7→J8→J4) is marginally faster than the ramp route (J2→J3→J4) due to the ramp’s low speed (18 kph vs. 24–30 kph on bypass roads), so even the initial dispatch prefers the bypass. As a result, the ramp capacity constraint does not activate during normal operation in this model — a finding documented clearly under ramp_upgrade and ramp_closed results.

Limitations


Performance Measures

MeasureDefinitionUnit
total_tonnes_deliveredSum of payload_tonnes for all dump events completing before shift endtonnes
tonnes_per_hourtotal_tonnes_delivered / shift_length_hourst/h
average_truck_cycle_time_minMean duration of completed truck cycles (dispatch-to-dump-end)minutes
average_truck_utilisationMean fraction of shift time each truck spent in an active cycledimensionless
crusher_utilisationsum(dump_service_times) / shift_length_mindimensionless
loader_utilisationsum(load_service_times) / shift_length_min per loaderdimensionless
average_loader_queue_time_minMean time trucks waited to be served by a loaderminutes
average_crusher_queue_time_minMean time trucks waited to be served by the crusherminutes

Uncertainty is reported as 95% t-distribution confidence intervals across 30 independent replications.

README

Mine Haulage Throughput Simulation

A discrete-event simulation (DES) built with SimPy to estimate ore throughput to the primary crusher over an 8-hour shift under multiple scenarios.


Installation

pip install simpy numpy pandas scipy matplotlib networkx pyyaml

Python 3.9+ required. No other dependencies.


Running the Simulation

# Run all six required scenarios (30 replications each)
python sim.py

# Run a single scenario
python sim.py --scenario baseline

# Override replications (e.g. 5 for quick testing)
python sim.py --replications 5

# Include topology visualisation
python sim.py --plot

# All options combined
python sim.py --plot --replications 30

All output files are written to the same directory as sim.py.


Output Files

FileDescription
results.csvPer-replication metrics for all scenarios (180 rows)
summary.jsonScenario-level aggregated stats with 95% CI
event_log.csvTruck event trace for the first replication of each scenario

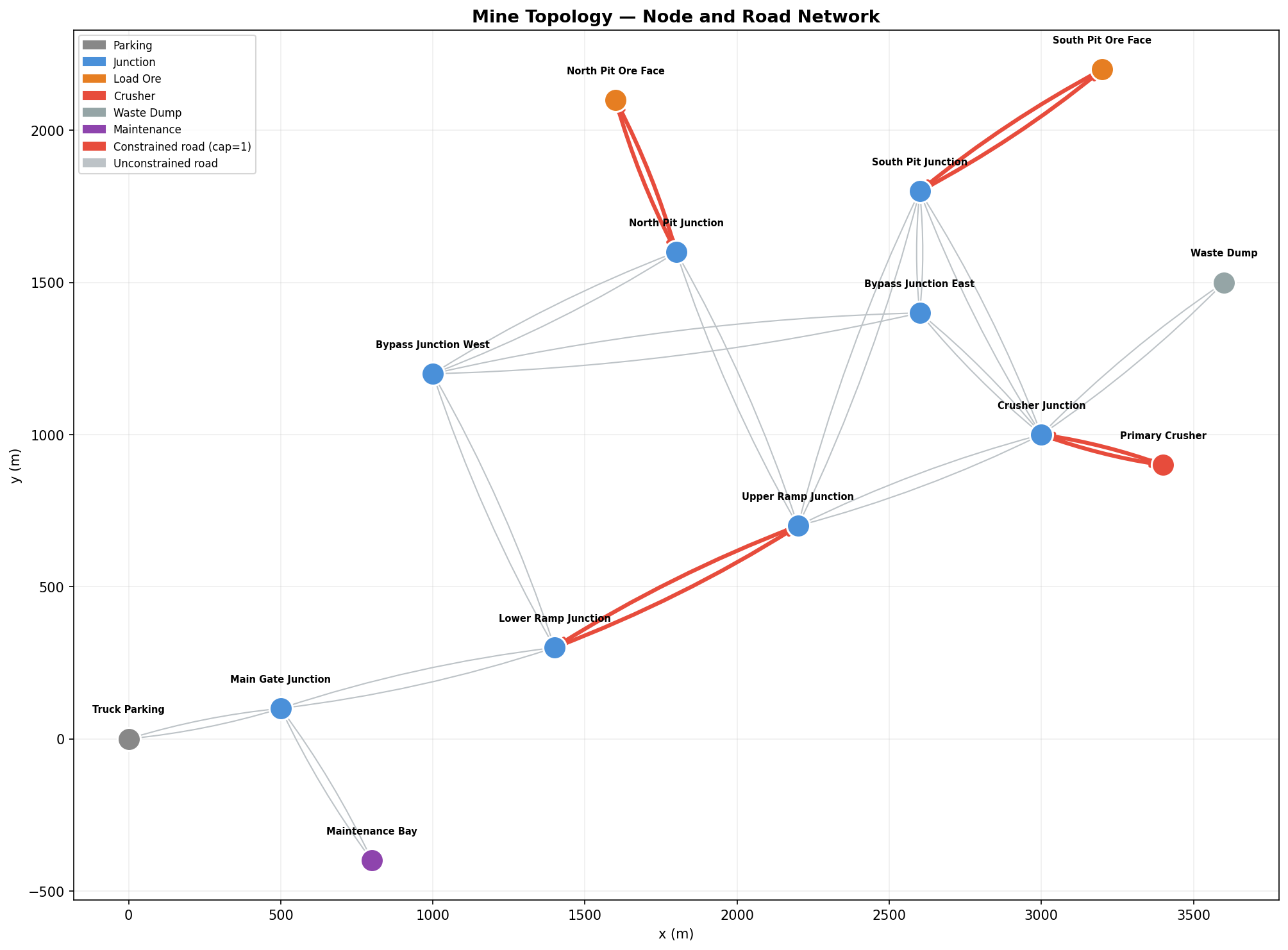

topology.pngNetwork visualisation (generated with --plot)
conceptual_model.mdFull model design documentation

Conceptual Model (Summary)

Full details in conceptual_model.md.

System boundary: 8-truck (baseline) ore haulage fleet cycling between two ore loading faces and one primary crusher. Capacity-constrained single-lane road segments are modelled explicitly. Waste haulage is excluded.

Entities: Trucks (active agents with 100 t payload).

Resources:

Truck cycle:

PARK → [dispatch] → travel empty → queue at loader → load →
       travel loaded → queue at crusher → dump → [repeat from crusher]

Events: dispatch, edge_depart, loader_queue_join, load_start, load_end, crusher_queue_join, dump_start, dump_end.


Assumptions

  1. Shortest travel-time path (Dijkstra) recalculated at each dispatch decision
  2. Dispatching: nearest-available-loader with queue-length penalty
  3. Service times: truncated-normal at zero (loading, dumping)
  4. Travel time noise: lognormal multiplier with mean=1, CV=0.10 per edge
  5. Trucks cycle pit↔crusher continuously (do not return to PARK between cycles)
  6. Fleet scenarios use the first N trucks from trucks.csv
  7. Loaders 100% available throughout shift; no breakdowns modelled
  8. Shift cutoff is strict: only dumps completing before 480 min are counted

Routing and Dispatching Logic

Routing

NetworkX shortest_path with travel_time_min as the edge weight. Travel time for each edge is distance_m / (max_speed_kph × 1000/60) in minutes. Loaded trucks travel at 85% of edge speed; empty trucks travel at 100%.

Closed edges are removed from the graph before route-finding, so ramp-closed scenarios automatically reroute via available paths (the bypass: J2→J7→J8→J4).

If no path exists, the simulation raises a ValueError with a clear message rather than continuing silently.

Dispatching

At each dispatch decision (just before travelling to a loader), the truck scores each available loader as:

score = travel_time_to_loader + len(loader_queue) × mean_load_time

The loader with the lowest score is selected. This approximates expected cycle time before production begins, balancing distance and congestion.


Key Results

Scenario Summary Table

ScenarioMean tonnes95% CIt/hCrusher utilAvg crusher queue
baseline12,447[12,362–12,531]1,55690.7%3.84 min
trucks_48,163[8,125–8,202]1,02059.2%0.30 min
trucks_1212,677[12,579–12,774]1,58592.4%14.85 min
ramp_upgrade12,467[12,384–12,549]1,55890.8%3.84 min
crusher_slowdown6,423[6,356–6,491]80393.7%28.18 min
ramp_closed12,447[12,362–12,531]1,55690.7%3.84 min

30 replications, 8-hour shift, base seed 12345.


Operational Decision Questions

1. What is the expected ore throughput during the baseline 8-hour shift?

12,447 t ± 84 t (95% CI), equivalent to 1,556 t/h.

Mean truck cycle time is 29.9 min. The crusher runs at 90.7% utilisation with an average queue wait of 3.84 min, indicating the crusher is the system’s primary constraint.

2. What are the likely bottlenecks?

The primary crusher is the dominant bottleneck:

Secondary constraints:

The ramp (E03_UP/E03_DOWN) is not a bottleneck in steady-state operation. See question 4 for explanation.

3. Does adding more trucks improve throughput, or does the system saturate?

Adding trucks yields diminishing returns — the system is saturated at the crusher.

FleetMean tonnesChange vs baseline
4 trucks8,163−34.5%
8 trucks (baseline)12,447
12 trucks12,677+1.8%

Going from 4→8 trucks adds 4,284 t (+52%). Going from 8→12 trucks adds only 230 t (+1.8%). Crusher utilisation rises from 90.7% to 92.4% with 12 trucks, and queue wait more than triples (3.84→14.85 min). The system is effectively saturated; additional trucks only pile up at the crusher.

Recommendation: the fleet of 8 trucks is already at or past the point of efficient crusher utilisation. Investment in additional trucks is not justified without also increasing crusher throughput.

4. Would improving the narrow ramp materially improve throughput?

No. Ramp upgrade yields only +0.2% throughput improvement (+20 t).

Two structural reasons:

  1. The ramp is not on the steady-state cycle. After their initial dispatch from PARK, trucks cycle between pit loading faces (above the ramp, at J3/J5/J6 level) and the crusher (via J4, also above the ramp base). The path LOAD_N→J5→J3→J4→CRUSH and CRUSH→J4→J3→J5→LOAD_N does not pass through J2 or the ramp. Only the first trip of each truck (PARK→loader) traverses the ramp section.

  2. The bypass is already faster. The bypass route PARK→J1→J2→J7→J5→LOAD_N takes 9.9 min, compared to 10.3 min via the ramp (which is slow at 18 kph). So even in the baseline scenario, trucks prefer the bypass for their initial dispatch, and the ramp’s capacity constraint never activates.

Implication: capital investment in ramp widening or road upgrade would not improve throughput in this model. The design assumption that the ramp is the “intended bottleneck” does not translate to a steady-state constraint given the cycle structure.

5. How sensitive is throughput to crusher service time?

Highly sensitive. Doubling crusher service time halves throughput.

Crusher mean serviceMean tonnesvs baseline
3.5 min (baseline)12,447 t
7.0 min (crusher_slowdown)6,423 t−48.4%

The crusher_slowdown scenario (7.0 min vs. 3.5 min mean service time) reduces throughput by 48%, with crusher queue wait rising from 3.84 to 28.18 min. Crusher utilisation rises to 93.7% and trucks spend most of their time waiting.

Recommendation: crusher reliability and service rate are the highest-leverage intervention point. Preventive maintenance schedules, wear liner replacement timing, and feed optimisation should be prioritised over fleet expansion.

6. What is the operational impact of losing the main ramp route?

No measurable impact on throughput (0% change).

As explained in question 4, trucks do not use the ramp in steady-state cycling. When the ramp is closed, the model automatically routes the initial dispatch via the bypass (J2→J7→J5), which is already the preferred route. The result is statistically identical to baseline.

Caveat: this finding depends critically on the model assumption that trucks do not return to PARK (and therefore through the ramp) between cycles. If operational procedures require trucks to check in at a dispatch point below the ramp between loads, the ramp would become a meaningful constraint. This is a model limitation worth investigating with actual operational data.

Additional scenario: Loader upgrade at North Pit

Reducing LOAD_N service time from 6.5 min to 4.5 min (matching LOAD_S) would eliminate the loader queue imbalance. Given that the crusher is the binding constraint, the expected throughput gain is modest — but it would reduce the 2.6 min average loader queue wait, improving truck utilisation and cycle predictability.


Bottleneck Summary

  1. Primary crusher — 90.7% utilised, avg 3.84 min queue. Adding trucks worsens congestion. This is the binding constraint.
  2. North Pit loader (L_N) — slower service (6.5 vs 4.5 min), causing loader queue imbalance. Trucks preferentially dispatch to L_S.
  3. Single-lane face roads (E07, E09) — minor constraint; trucks occasionally queue for access to loading faces.
  4. Main ramp — not active in steady-state cycle; not a bottleneck in this model.

Model Limitations


Suggested Further Scenarios

  1. loader_upgrade: Reduce LOAD_N service time to 4.5 min — test whether loader speed is a secondary constraint
  2. crusher_capacity_2: Model a second crusher or parallel dump point to quantify throughput ceiling
  3. mixed_fleet: Introduce larger-payload trucks (e.g., 150 t) to test payload sensitivity
  4. return_to_park: Require trucks to return to PARK between cycles to activate ramp bottleneck and validate ramp sensitivity assumptions
